Thursday, May 15, 2026
Est. 2026 · Independent
Tracking data center opposition across all 50 states. 1,100+ community reports and counting.
Breaking — July 16, 2026
New York just became the first state to pause data centers — Gov. Hochul signed Executive Order 62, freezing state environmental permits for 50 MW+ facilities for up to a year. Trump attacked it Wednesday, saying the companies “are now being sought in Alabama, Florida, Texas, Arizona.” Nationwide, 75 projects worth $130 billion were blocked in Q1 2026 alone — matching all of 2025.
The Story So Far

Florida was supposed to host some of the largest AI data centers in America. Residents keep finding out in time.

Since February, Florida residents have stopped five: St. Lucie's $13.5 billion Sentinel Grove, Okeechobee's Okee-One, Martin County's Silver Fox, Citrus County's Deltona expansion — withdrawn one day after commissioners refused to delay the vote past the election — and Palm Beach County's Project Tango, denied 5–1. Nassau froze data centers county-wide before anyone had even applied; Citrus passed its own moratorium with Deltona’s application already pending and exempt — which is exactly why Deltona had to withdraw to escape a vote. Fort Meade is the one that got through: 4.4 million square feet approved by a city of 5,300, now facing two lawsuits and a recall. And in Westview, a Miami-Dade neighborhood, one is already going up — filed as a “telecommunications hub,” permitted by right, notice mailed 500 feet. Nobody voted on that one at all.

8counties
With active or proposed hyperscale projects
$20B+
In announced private capital investment
38Msq ft
Total proposed data center floor space
1.2gigawatts
Power needed for Fort Meade alone — enough for 500,000 homes
Statewide Risk Map

How risky is your county?

All 67 Florida counties, shaded by data center development risk. The darker the county, the more structurally attractive it is to hyperscale developers — based on power availability, water capacity, land availability, and proximity to existing projects.

Eight markers, every tracked Florida project. Five were stopped — withdrawn, canceled, or denied. One was approved and is now being sued. One is already under construction. The eighth is Nassau, which passed a moratorium with nothing pending. Citrus passed one too, with an application already in the queue. Click any county to see its risk score and read the full report.

Risk Tier
Very High
High
Moderate
Low
Active Projects
Approved
Denied
Withdrawn

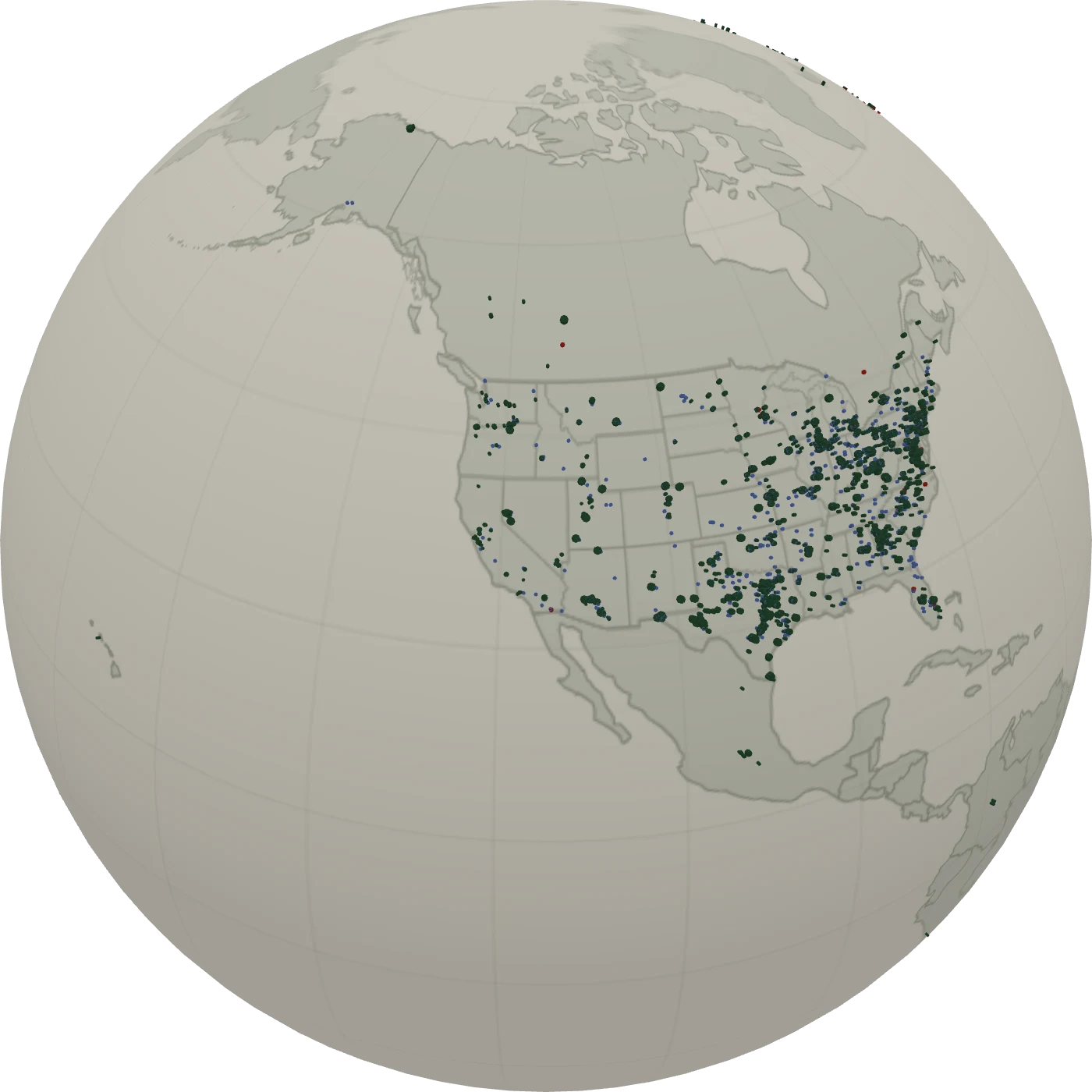

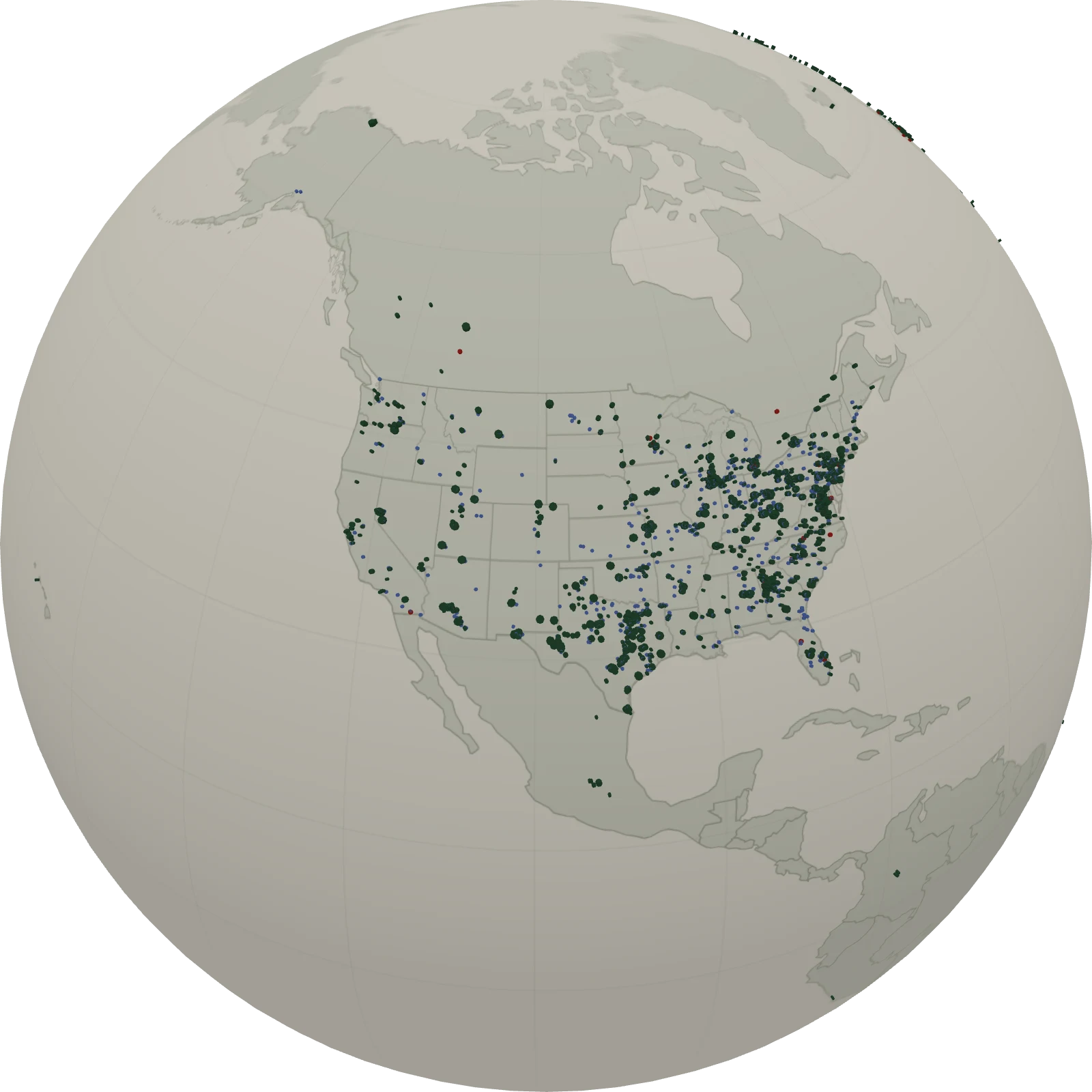

Nationwide Data
Community Reports (1,100+)
Verified Projects (150+)
Loading county data…
What You Can Do Right Now

We send an opposition letter to your commissioners for you.

Okeechobee's data center is dead — killed after 3,000 residents pushed back. Fort Meade's approval is being challenged in court by residents. Written opposition works.

Enter your address and pick your concerns. We research your commissioners, write a personalized letter citing state statutes and project data, and email it to every commissioner on your behalf.

Take Action Now 1,143 letters sent
60 seconds. Works in any state. Letter sent within 24 hours.
Sample Letter Preview
To: Commissioner Maria Sachs, Commissioner Gregg Weiss, Commissioner Sara Baxter
From: Jane Smith via Florida Data Centers
Subject: Opposition to Proposed Data Center — Palm Beach County

Dear Commissioners,

My name is Jane Smith and I reside at 4521 Arden Way, Loxahatchee, FL 33470 — within 2.3 miles of the proposed Central Park Commerce Center (Project Tango) site.

I am writing to formally oppose the rezoning application for 202 acres of data center development adjacent to FPL's West County Energy Center. My concerns include the impact on residential property values, groundwater supply, and noise from industrial cooling systems operating 24/7.

Under Florida SB 484, which took effect July 1, 2026, utilities are prohibited from shifting data center infrastructure costs onto residential ratepayers. Additionally, under Florida's Sunshine Law (Chapter 286) and Public Records Act (Chapter 119)...

See full letter →
National Data Center News
Maine
Statewide moratorium vetoed — override vote falls just short
Bipartisan supermajority passed LD 307. Gov. Mills vetoed. Override failed by a handful of votes.
Wisconsin
Regulators approve new data center tariff — full cost of service required
We Energies customers must fund all generation and grid infrastructure. Port Washington referendum wins 2:1.
New Jersey
Kenilworth residents show up with cowbells to fight data center 17 mi from NYC
Community packed council meeting with whistles and noise. Suburban NJ rebellion grows.
Florida
SB 484 signed into law — data centers must pay full cost of service
DeSantis signed May 7 in Lakeland. Effective July 1. NDA loophole remains. Project Tango denied 5–1 on July 15.
All 50 States →
Wear the Record

The opposition, in cotton.

Every shirt, hat, and flag puts money back into the fight — research, outreach, and keeping this work independent. Wear it to a hearing, a meeting, or down your own street, and put the opposition where your neighbors can see it.

New Arrivals
View full collection →
Deeper Analysis

Want your county's full risk report?

The map above shows the tier. The full report shows the breakdown: power availability, water capacity, land availability, and current exposure to known projects — each scored and explained in plain English for your specific county.

Find your county's full report
How counties score
Power availability 30
Current exposure 40
Water capacity 15
Land availability 15
By County

Every known data center proposal in Florida.

Updated weekly
Palm Beach County
South Florida · Pop. 1.5M
Home to Project Tango, the proposed hyperscale campus near Loxahatchee that sits 1.8 miles from Lion Country Safari. After three delays and a 12-hour hearing, commissioners denied the application 5–1 on July 15, 2026 — without prejudice. The site still holds approval for 2M+ sq ft of warehouse and data center that the vote did not touch.
Full Palm Beach coverage
Central Park Commerce Center (Project Tango)
Denied · July 15, 2026
202 acres 3.7M sq ft 11 data center buildings, up to 75 ft tall Loxahatchee, near Arden
Developer PBA Holdings is seeking approval for 1.79 million sq ft of data storage plus 1.9 million sq ft of warehouse. The end user is shielded from public records under a 2017 Florida statute that allows developers to keep operator identity confidential. The site sits adjacent to FPL's West County Energy Center — a 3,750-megawatt natural gas plant that can power 750,000 homes. Residents of Arden, a 2,300-home community with a new elementary school on former Palm Beach Aggregates land, say they learned of the proposal four days before the zoning hearing.
Polk County
Central Florida · Pop. 805K
Fort Meade — population 5,300 — would host Florida's first hyperscale data center if it is ever built. City commissioners approved the developer agreement unanimously on April 15, 2026, despite 40 of 41 public commenters speaking against it. Residents filed two lawsuits on May 14 asking a judge to void that approval entirely, and a recall effort is targeting three commissioners.
Full Polk coverage
Fort Meade Data Center Campus
Approved · Permits Pending
1,300 acres 4.4M sq ft potential buildout $2.6B investment 1.2 GW power needed Former phosphate mine, west of US-98
Developer Stonebridge (Maryland-based) has secured a 20-year development agreement, rezoning, and a $150M / 10-year tax break. The project still requires a water-use permit from the Southwest Florida Water Management District, which adopted a policy in December 2025 requiring any data center water permit to clear its full governing board at a public meeting where residents can object. SWFWMD told Fort Meade the day of the vote that the city's existing permit cannot supply the project. As of late April, Stonebridge had not applied. Florida's Commerce Secretary called the developer's 50,000 gal/day estimate “woefully underestimated” and the project “fundamentally flawed.” Powered by Duke Energy's Hines Complex. The operator tenant remains unidentified. Groundbreaking targeted end of 2026; operations by 2028. The city said commitments from Stonebridge include $10 million toward local infrastructure and roughly 450 permanent jobs averaging $107,000/year.
St. Lucie County
Treasure Coast · Pop. 355K
Site of two high-profile proposals near Fort Pierce. The largest — Sentinel Grove / Project Jarvis — was withdrawn in February 2026 pending new state legislation. A second, Atlas Compute, is in early planning.
Full St. Lucie coverage
Sentinel Grove Technology Park (Project Jarvis)
Withdrawn Feb 2026
1,218 acres 15M sq ft total buildout $13.5B projected investment Minute Maid Rd & Orange Ave, Fort Pierce
Proposed on former citrus grove land owned by Epic Estates 68 LLC, a Tallahassee-based land-banking firm that purchased the 1,218 acres for $15 million in July 2024. The St. Lucie County Planning and Zoning Commission voted 4–2 against recommending the comprehensive plan amendment in late 2025. Developers voluntarily withdrew the land-use application on February 26, 2026, citing advancing state legislation. The site remains agricultural. Developers are monitoring Florida SB 484 and related bills before deciding whether to refile.
Atlas Compute AI Data Center Campus
Early Planning
240 MW initial capacity Up to 1 GW potential Midway Industrial Park, Fort Pierce
Miami-based Atlas Compute has obtained zoning verification for a closed-loop, water-free cooling data center built in partnership with Penguin Solutions, specifically engineered for NVIDIA GPU workloads. No formal development application had been submitted as of early 2026. Target: operational 2027.
Okeechobee County
Heartland · Pop. 41K
The Okee-One data center is dead. The state accused IRSC of “falsehoods and pretenses about energy and water,” clawed back its $1.5M grant, and county commissioners struck the comp plan framework that would have enabled future data centers. A 3,000-signature petition in a town of 5,500 worked.
Full Okeechobee coverage
Okee-One Data Campus
Canceled April 2026
205 acres 9–10 MW initial (≈5% of Project Tango) Off Highway 441, near Okeechobee $1.5M state grant
Indian River State College envisions the campus as a data center and technical-workforce training site connected to programs in technology, cybersecurity, electrical systems, welding and HVAC. The project received a $1.5 million state grant under Gov. DeSantis. Residents at the April 2026 Okeechobee County Board of Commissioners meeting pressed the question "What's in it for us?" — raising concerns about expansion plans, electrical load and environmental impact. The site's history as a reform school where children faced physical abuse from state employees has added to the emotional weight of the debate.
Martin County
Treasure Coast · Pop. 164K
Two data center actions hit Indiantown. Silver Fox — a 606-acre, 2M sq ft hyperscale proposal — was withdrawn by its backers after heavy community opposition. The Tesoro Groves PUD, a 5,722-acre FPL rezoning, was approved unanimously on April 30, 2026 — council declined to add language banning data centers. A resident lawsuit challenging the rezoning was dismissed with prejudice on July 2, 2026, meaning it cannot be refiled.
Full Martin coverage
Tesoro Groves PUD (Silver Fox withdrawn)
PUD Approved · Apr 30, 2026
Indiantown, Martin County Rezoning approved 5–0 · April 30, 2026
Silver Fox 606 LLC — tied to Juno Beach contractor Nelson Ferreira — withdrew its 2M sq ft proposal after sustained resident opposition. FPL’s Tesoro Groves rezoning then passed anyway: the council approved the PUD framework unanimously on April 30, declining resident demands to explicitly prohibit data centers. FPL says the vote was zoning only, not a project, and agreed to cap development at 7,200 daily vehicle trips (~2M sq ft). Data processing centers remain an explicitly permitted use. Booker Park, a historically Black neighborhood, sits closest to the site.
Citrus County
Nature Coast · Pop. 160K
Deltona Corp has filed a comprehensive plan amendment request covering roughly 813 acres — early-stage planning that would rezone the land to allow data center development.
Full Citrus coverage
Deltona Corp Comprehensive Plan Amendment
Application Filed
~813 acres Developer: Deltona Corp
The amendment request is working through Citrus County's planning process. The scale is consistent with a hyperscale project. Residents have limited public information on operator, power source, or water plan as of the most recent disclosures.
Nassau County
Northeast FL · Pop. 103K
A 1,600-acre energy-integrated campus is planned near Jacksonville International Airport. Unusually, the project pairs a 200-MW smart microgrid with the data center itself — meaning on-site power generation.
Full Nassau coverage
NextNRG Nassau County Data Center Campus
Planning
1,600 acres 400 acres data center / 1,200 acres energy infra 200 MW microgrid, scalable Near Jacksonville Intl Airport
NextNRG proposes a phased buildout starting with 50 MW modules, scaling to 200 MW or more, with additional expansion potential across 6,000 nearby acres. The on-site power generation model is less common in Florida and raises separate questions about air emissions, backup generators, and the interaction with FPL's existing grid infrastructure.
Protections

Every pause has an expiration date.

Updated

Nineteen Florida jurisdictions have blocked data centers outright or frozen applications while they write rules. Three of those blocks are permanent. The rest are clocks — and when one runs out, the county is back to having no rules at all unless commissioners pass something first.

Open the full moratorium tracker →

Dates reflect the final vote as reported by local outlets and county postings. Some ordinances run from an effective date later than the adoption date, and a board can lift a pause early or extend it. Entries marked date unconfirmed have not been checked against the ordinance text and are shown without a countdown. Corrections — send them here.

2026 Legislative Session

Florida's data center rules are being rewritten — right now.

Four bills moved through Florida's 2026 legislative session that create the state's first framework for regulating hyperscale data centers. SB 484 was signed by Gov. DeSantis on May 7, 2026 in Lakeland — “You should not pay one more red cent for electricity because of a hyper-scale data center as an individual,” he said at the signing. The law prohibits utilities from shifting data center infrastructure costs onto residential ratepayers and preserves local zoning authority, but allows state agencies to sign NDAs with developers — hiding project details from the public for up to a year. DeSantis also pushed his “Artificial Intelligence Bill of Rights” (SB 482), which passed the Senate 35–2 but died in the House on March 13. He had it added to the April special session call; House Speaker Daniel Perez killed it on the session’s first day, April 28, 2026.

Only one of them became law. SB 484 passed both chambers, was signed May 7 and took effect July 1, 2026 as Chapter 2026-65. It bars utilities from shifting data center infrastructure costs onto residential ratepayers and preserves local zoning authority. The other three are dead. HB 1007 — Rep. Griff Griffitts’ House version, originally hyperscale-restrictive — was laid on the table March 11 and folded into SB 484. SB 1118, a public-records exemption, died on the calendar March 13. HB 1517, the “Florida Data Center Transparency Act,” was never heard by a single committee before the session adjourned. The disclosure requirements and the August 1 compliance deadline it proposed do not exist in Florida law.

SB 484 · Law
Signed into law May 7, 2026. Protects residential ratepayers, preserves local zoning authority, requires reclaimed water where feasible. Final version allows agency NDAs up to 12 months — a reversal from the original bill. Took effect July 1, 2026.
HB 1007 · Dead
Laid on the table March 11, 2026 and substituted for SB 484. Rep. Griff Griffitts’ House version was originally restrictive of hyperscale data centers, then rewritten in committee in February to mirror SB 484. Its provisions live on only insofar as SB 484 adopted them.
SB 1118 · Dead
Died on the calendar March 13, 2026. Would have created a public records exemption letting developers withhold "proprietary confidential business information" for up to 12 months while still disclosing that a project is a data center. Never became law — though SB 484’s final version allows agency NDAs up to 12 months regardless.
HB 1517 · Dead
Died without a committee hearing. Would have required detailed energy, water, carbon, and noise disclosures at the application stage, with existing facilities complying by Aug 1, 2026. It was never heard by the Economic Infrastructure Committee before the session adjourned sine die on March 13. No such deadline exists.
Join the Stop Data Centers group

Public group · Free to join
